Cell & Gene Therapy Catapult

Cell & Gene Therapy Catapult Expansion Phase 2

Merit Transforms Cell & Gene Therapy Landscape with Rapid Expansion of CGTC Facility

Cell & Gene Therapy Catapult (CGTC) stands as the UK’s flagship facility dedicated to advancing cell and gene therapies. This government-backed initiative supports CGT companies in progressing their therapies from initial stages through to clinical trials, before transitioning to dedicated manufacturing sites.

Merit proudly served as the Principal Contractor for the expansion project, designing and delivering an impressive 1,800m2 of GMP space, featuring six 200m2 modules. The project was completed within a remarkable 40-week timeline from contract award to Operational Qualification (OQ).

The CGTC project marked a major milestone in Merit’s innovative approach to offsite facility design, as the team utilised a platform design which set the foundation for future repeatable facility design.

Merit’s comprehensive scope for CGTC encompassed the design and development of process areas, along with civil, structural, architectural and MEP systems. The facility was designed to meet Grade B standards and BSL 2 containment.

Furthermore, this project exemplified our commitment to quality through extensive collaboration with the client. Detailed discussions and extensive workshops focused on critical aspects to ensure that the facility would meet the highest operational and compliance requirements.

Client
Cell & Gene Therapy Catapult
Location
Stevenage
Sector
Life Sciences
Project
Expansion Phase 2

Key Features

  • Merit was tasked with both validating the design for Phase 2 and providing a fixed price lump sum through open book tendering.
  • Works delivered in complex GMP facility.
  • MHRA licensed facility.
  • Project within large scale operational campus requiring constant stakeholder engagement and traffic management to avoid business interruptions and ensure staff safety.
  • Large proportion of works self-performed by Merit including MEP and cleanroom, significantly reducing schedule and quality risk.

Key Outcomes

  • Achieved ISO5 Class 100 standards (Grade B ‘At Rest’, Grade C ‘In Operation’) according to ISO 14644.
  • Provided containment for Biosafety Level 2 (BSL2).

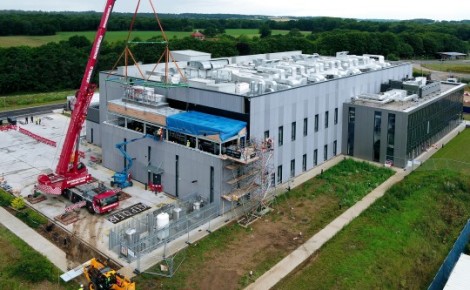

  • Reduced on-site personnel by 70% through offsite construction, lowering facility carbon footprint and enhancing health and safety.

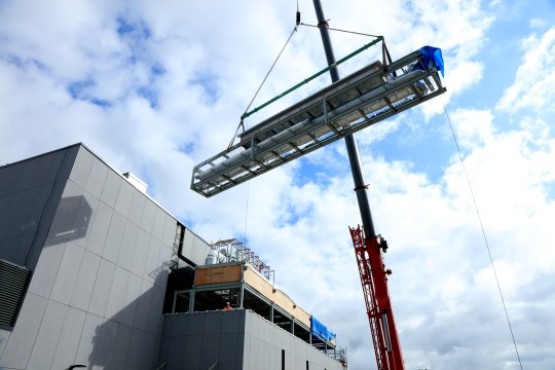

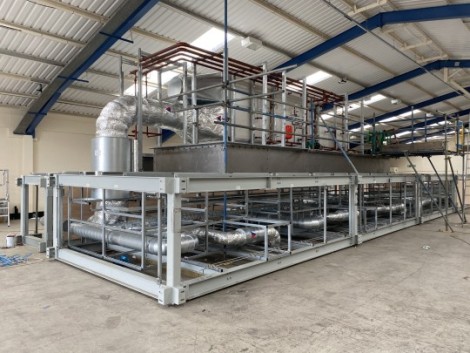

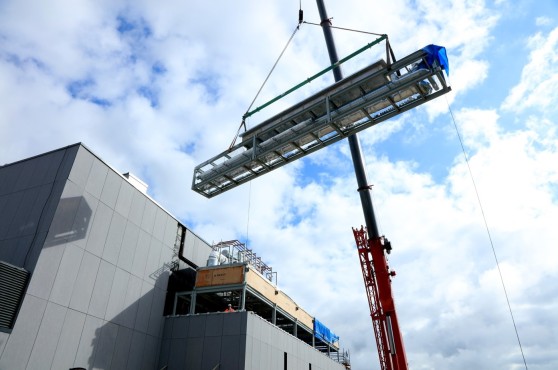

  • Utilised a Pre-Assembled Modules (PAMs) approach with 60% of construction completed offsite at Merit’s Cramlington-based smart factory.
  • Implemented self-delivered MEP and cleanroom construction, saving 10% of project value by eliminating Tier 2 overhead costs and reducing management interfaces.
  • Increased UK equipment content for enhanced cost-efficiency, quality and schedule improvement.

Want to discuss your next project?

Get in touch

More life science projects

Sign up to our newsletter

This site is protected by reCAPTCHA and the Google Privacy Policy and Terms of Service apply.

Sign up to our newsletter

Keep up to date on all the latest news, blogs and insights

This site is protected by reCAPTCHA and the Google Privacy Policy and Terms of Service apply.

This website uses cookies to ensure you get the best experience on our website. Please let us know your preferences.


Please read our Cookie policy.

Manage
